Pyrolysis plant operations — diagnosing and optimizing performance issues

Pyrolysis Plant Troubleshooting

Many pyrolysis plants operate well below their potential — producing 20-40% less oil than expected, with quality issues that limit market access. APChemi's troubleshooting service provides independent, expert diagnosis of operational problems and actionable solutions to optimize performance, regardless of who built your plant.

20-40%
Typical Underperformance
15-40%
Yield Improvement
2-6 mo
ROI Payback
Any Plant
We Troubleshoot All
APChemi engineer diagnosing pyrolysis plant operational issues

Common Problems We Solve

Low oil yield (20-30% below expected)

Causes

Wrong temperature profile, excessive cracking to gas, poor condensation efficiency, feedstock quality issues

Solution

Temperature optimization, condenser redesign, feedstock pre-processing improvement

Poor oil quality (high sulfur, particulates)

Causes

Inadequate gas cleaning, wrong condensation temperature, feedstock contamination (PVC, dirt)

Solution

Gas cleaning upgrades, condensation train optimization, feedstock sorting improvement

Reactor coking / blockages

Causes

Hot spots, inadequate mixing, wrong residence time, feedstock melting and bridging

Solution

Heat distribution improvement, reactor internal modifications, feed system redesign

High energy consumption

Causes

Poor insulation, gas leaks, inefficient burner design, no heat recovery

Solution

Insulation upgrades, leak detection and repair, burner optimization, heat recovery system

Excessive downtime / maintenance

Causes

Thermal cycling damage (batch), corrosion from chlorine/sulfur, bearing failures, seal degradation

Solution

Material upgrades, corrosion protection, maintenance schedule optimization

Environmental compliance failures

Causes

Inadequate emission controls, odor issues, wastewater management gaps

Solution

Emission control upgrades, gas treatment systems, environmental management plan

Pyrolysis plant undergoing diagnostic inspection and performance optimization

The Cost of Underperformance

A plant operating at 60% of its potential doesn't just lose 40% of revenue — it often also has higher operating costs, increased maintenance, and quality issues that further reduce margins.

Lost Revenue: 20-30% lower yields = $200K-$1M+/year lost income

Higher Costs: Excess energy, maintenance, and downtime = $50K-$300K/year

Quality Penalty: Selling lower-grade oil at $50-$150/tonne discount

Troubleshooting cost: $5K-$100K — pays for itself in 2-6 months

Is your pyrolysis plant underperforming? APChemi's engineers have 17+ years of experience diagnosing and fixing operational issues in plants worldwide.

Contact Us

Root Cause Analysis: 9 Technical Challenges

Beyond the symptoms above, our engineers have identified 9 fundamental technical root causes that underlie most pyrolysis plant failures. Understanding these helps you diagnose whether your plant has design-level issues that need engineering solutions — not just operational tweaks:

1

Improper Air Lock Feeding

Safety hazard, 10-20% yield loss

Feeding systems without proper air locks allow oxygen into the reactor during material loading. This creates safety hazards from uncontrolled combustion and causes 10-20% yield loss as valuable hydrocarbons are burned rather than recovered as oil.

2

Air Leaking into Pyrolysis Reactor

Explosion risk, product degradation

Seal failures, worn gaskets, or poor-quality flanges allow ambient air to enter the oxygen-free reactor environment. Even small air ingress causes partial combustion of pyrolysis vapours, degrading product quality and creating serious explosion risk.

3

Incorrect Material of Construction

Reactor failure in 1-2 years

Using mild steel or low-grade alloys where high-temperature corrosion-resistant materials are needed. Reactors operating at 400-600°C with corrosive feedstocks (sulfur from tires, chlorine from PVC contamination) require specific metallurgy — cheap materials mean reactor failure in 1-2 years.

4

Tar Clogging Vapour Pipelines

Production shutdown, fire risk

Heavy tar fractions condense in vapour transfer lines when temperatures drop below the tar dew point. Without proper heat tracing, insulation, and pipeline design, tar buildup causes blockages that shut down production and create fire risk from accumulated flammable deposits.

5

Carbon Carry-Over from Reactor

Poor oil quality, condenser fouling

Fine carbon particles and char dust are entrained in the pyrolysis vapour stream due to excessive gas velocities, poor reactor internals, or turbulent flow patterns. This contaminates the oil product and fouls downstream condenser surfaces.

6

Tar Clogging of Condenser Systems

15-30% oil recovery loss

Condenser designs that don't account for tar separation allow heavy fractions to coat heat exchange surfaces, progressively reducing cooling efficiency. Oil recovery drops 15-30% as vapours pass through without condensing, escaping as non-condensable gas losses.

7

Energy Imbalance Requiring External Fuel

$3K-$10K/month extra fuel cost

Poorly designed plants cannot utilise their own non-condensable gas (NCG) for process heating, requiring purchased LPG, diesel, or natural gas. This adds $3,000-$10,000/month in fuel costs and destroys project economics.

8

Improper Reactor Design (Under-Capacity)

30-50% capacity loss

Reactors with insufficient heat transfer area, poor mixing, or undersized dimensions cannot process the nameplate feedstock throughput. The result: 30-50% capacity loss compared to what was promised, with proportional revenue reduction.

9

Reduced Equipment Safety and Mechanical Strength

Structural failure risk

Cost-cutting on structural steel, pressure vessel thickness, support structures, and safety relief systems creates risk of catastrophic mechanical failure. This is particularly dangerous in high-temperature, high-pressure pyrolysis environments.

Our Troubleshooting Approach

1

Remote Data Review

We analyze your plant drawings, operating data, product test results, maintenance logs, and performance history to identify likely root causes before visiting your site.

P&ID review Operating data Product tests
2

On-Site Diagnostic Visit

Our engineers inspect your plant, observe operations, take measurements, and interview operators. Typically 3-5 days of intensive on-site assessment.

Visual inspection Measurements Operator interviews
3

Root Cause Analysis

Critical Phase

Comprehensive engineering assessment identifying ALL factors contributing to underperformance — not just symptoms, but fundamental root causes.

4

Solution Design

Prioritized list of modifications ranked by cost, impact, and implementation timeline. Quick wins identified alongside longer-term improvements.

5

Implementation Support

Engineering drawings, equipment specifications, and on-site supervision for modifications. APChemi can manage the full remediation project if needed.

6

Performance Verification

Results Confirmed

Post-modification monitoring to confirm improvements are achieved. We measure actual performance gains against pre-troubleshooting baseline.

We Troubleshoot Any Plant

APChemi provides independent troubleshooting for pyrolysis plants regardless of origin. Our assessment is objective — we have no interest in protecting the reputation of the original builder.

🇨🇳

Chinese-Manufactured Plants

Commonly experience quality control issues, poor condensation design, and safety gaps. These are the most frequent troubleshooting requests we receive.

Common issues: condensation, safety, quality control
🇮🇳

Indian-Manufactured Plants

Often need optimization of temperature profiles and emission controls to meet international standards and maximize product quality.

Common issues: temperature, emissions, optimization
🇪🇺

European-Designed Plants

May need feedstock adaptation for different waste streams or capacity optimization to improve economics at current operating conditions.

Common issues: feedstock adaptation, capacity
🔧

Self-Built / Custom Plants

Frequently have fundamental design flaws that limit performance. These often need the most comprehensive engineering review.

Common issues: design flaws, process fundamentals

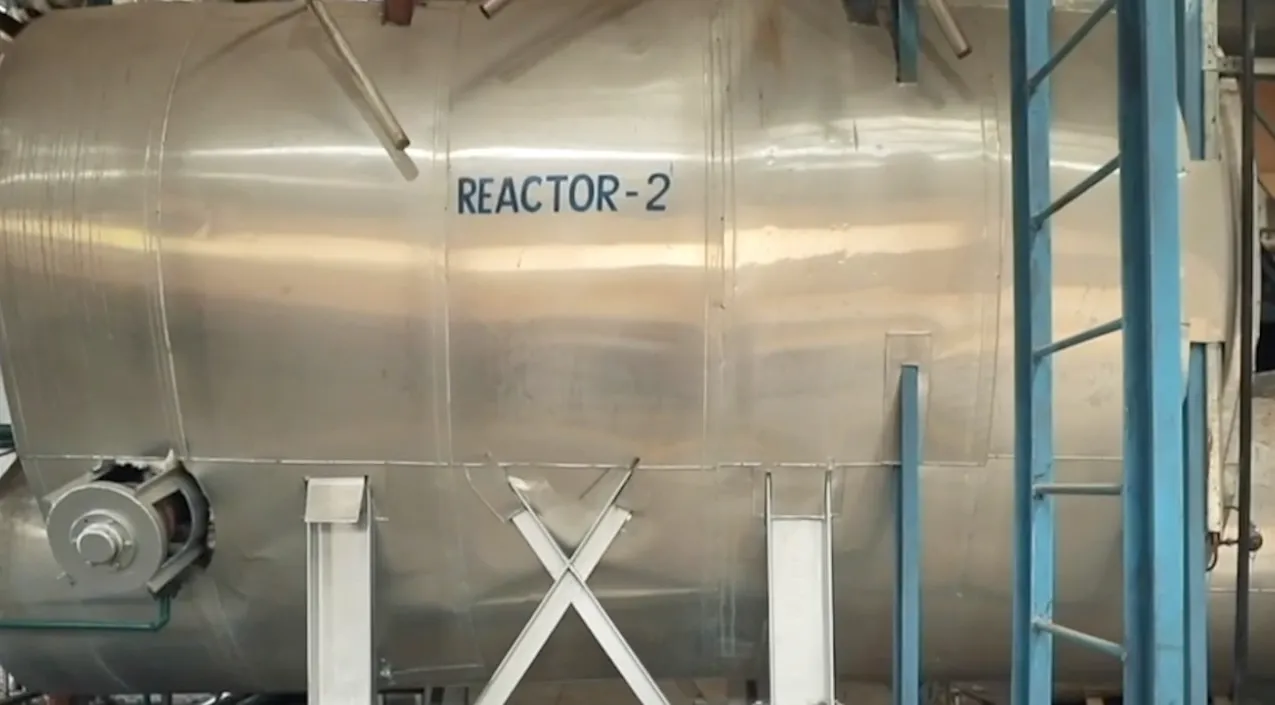

APChemi anti-coking reactor technology for preventing reactor blockages

Patented Anti-Coking Technology

Reactor coking is one of the most common and expensive problems in pyrolysis plants. APChemi has developed and patented anti-coking reactor designs that prevent carbon buildup through optimized heat distribution and internal geometry.

12+ patents covering reactor design, process optimization, and product quality improvements. When we troubleshoot your plant, we bring proprietary solutions that most other consultants cannot offer — upgrading your operations toward APChemi's 7x better standard across energy efficiency, safety, flexibility, cost, anti-coking, scalability, and oil purity.

Typical Results

Oil Yield Improvement

15-40%

Increase through temperature optimization and condensation system upgrades

Oil Quality Improvement

Grade Up

Sulfur reduction, particulate removal, and water content reduction for higher selling prices

Energy Cost Reduction

20-35%

Through heat recovery, insulation, and gas recycling improvements

Uptime Improvement

20-50%

Reduction in unplanned downtime through root cause elimination

ROI on Troubleshooting

2-6 Month Payback

Most clients see full payback on troubleshooting investment within 2-6 months through improved revenue and reduced operating costs. A $15K-$50K troubleshooting engagement typically recovers $100K-$500K+ annually in improved performance.

APChemi engineers providing on-site training and troubleshooting support

On-Site Engineering Support

APChemi's troubleshooting team doesn't just deliver a report — we stay involved through implementation. Our engineers provide hands-on support to ensure modifications achieve the targeted performance improvements.

  • On-site supervision during modifications
  • Operator training on optimized procedures
  • Commissioning support after upgrades
  • Performance monitoring and verification

Troubleshooting Investment

Remote Assessment
$2,000 - $5,000
Data & Drawings Review
  • P&ID and drawing review
  • Operating data analysis
  • Preliminary root cause identification
  • Recommendations report
Timeline: 1-2 weeks
Most Common
On-Site Diagnostic
$5,000 - $15,000
+ Travel Expenses
  • Everything in Remote
  • 3-5 day on-site inspection
  • Comprehensive root cause analysis
  • Prioritized modification list
  • Engineering specifications
Timeline: 3-5 weeks total
Full Remediation
$15,000 - $100,000+
Complete Plant Optimization
  • Everything in On-Site
  • Redesign and engineering drawings
  • On-site supervision of modifications
  • Operator training
  • Performance verification
Timeline: 2-6 months

Powered by APChemi — Independent Pyrolysis Expertise

49+
Plants Designed
12+
Patents
17+
Years Experience
227M+
Kg Processed
Global
NL, India, UK
3+
ISCC Plants

Diagnostics

Root cause analysis & identification

Redesign

Engineering modifications & upgrades

R&D Testing

Diagnostic lab analysis

Verification

Performance monitoring & sign-off

Frequently Asked Questions

Get a Free Consultation

Tell us about your pyrolysis project and our engineers will get back to you within 24 hours.

Contact Us →
49+ projects delivered ISCC Plus Certified 17+ years experience
